The city of Nice opts for the “Tram-Metro” solution by 2016.

Latest News

I have therefore listened a lot and reflected, even too much according to some who asked me to decide as quickly as possible. But I believe that this preparatory work should not be rushed under any circumstances, so I took the necessary time for quality work, betting on collective intelligence. I came to realize that I was definitely not alone in having great and beautiful ambitions for Nice Cรดte d’Azurโ€ฆโ€ It was a true compromise choice that Christian Estrosi proposed during the conference on the โ€œtransport planโ€ of the Nice Cรดte d’Azur Urban Community, thus taking up the ideas and proposals of members from the various working groups, from both his majority and the opposition.

โ€œIt was out of the question to repeat the same mistakes as for line 1 concerning the routes Dante / Buffa / Libertรฉ/ Hรดtel des Postes / Pastorelli / Joffre. That is why I decided that this section would be underground between Grosso and Arson Square, to emerge and join the air at Riquier.โ€ Thus, the East/West line 2 will start from St. Augustin to the intersection of rue de France and Grosvenor Boulevard using the existing bus route, passing through 7 stations (Cassin / Saint-Augustin, Cassin/Kirchner, Parc Ferber, Vallon Barla, Fabron/Hรดpital Lenval, Magnan, and Grosso) to then go underground to the SNCF station of Riquier, passing through 8 stations (Alsace Lorraine, Musiciens, Jean Mรฉdecin (with a connection to line 1), Place Wilson (serving the future Town Hall), Garibaldi (with a connection to line 1), Ile de Beautรฉ (the port), Place Arson, and terminating at the Riquier Station.

Line 1 has not been forgotten considering its extension is also scheduled for 2011, with it extending to Pasteur Hospital, then to Ariane and La Trinitรฉ, while line 3 will accompany the OIN project linking the Nice Cรดte d’Azur Airport to the future Grand Stadium with a new depot located on the Var plain.

A transport plan unveiled and new projects aiming to improve the daily life of the people of the Cรดte dโ€™Azur, the calendar is well filled for the coming years with a budget estimated at 450 million euros for the completion of line 2.

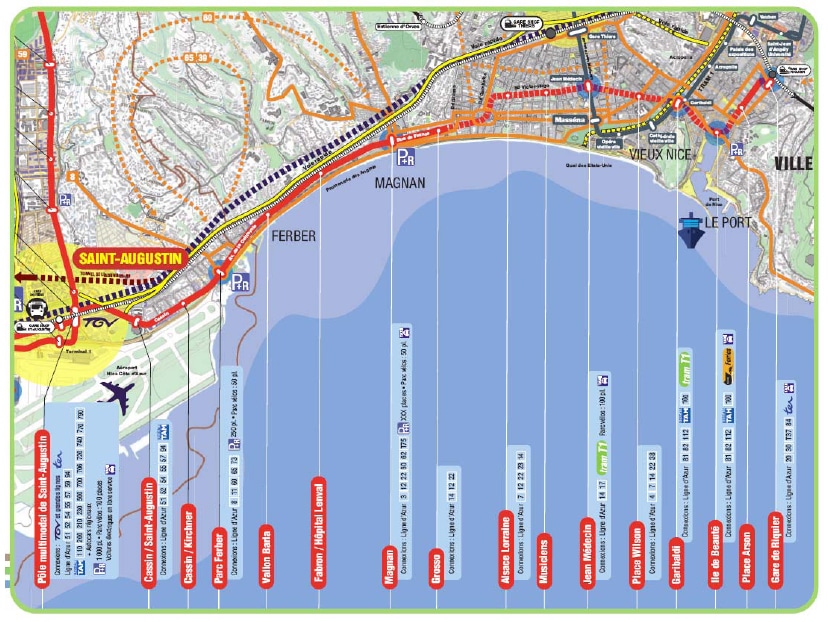

Click on the thumbnail to enlarge the plan.


The Work Schedule

jpg_jpg_tram-logo.jpg From 2010 to 2012: Improvement and creation of performances of dedicated East/West bus routes,

jpg_jpg_tram-logo.jpg 2011: Start of works for the extension of line T1

jpg_jpg_tram-logo.jpg 2013: Commissioning of the extension of line T1 to Pasteur, start of tunnel drilling works in downtown for line T2, and start of works for line T3 (Airport – Grand Stadium),

jpg_jpg_tram-logo.jpg2014: Start of works on Avenue de la Californie for line T2

jpg_jpg_tram-logo.jpg2015: Commissioning of tramway line T3, Var plain Airport / Grand Stadium

jpg_jpg_tram-logo.jpg2016: Commissioning of tram line T2, West-East connection: St Augustin-Port

jpg_jpg_tram-logo.jpgAfter 2016: Continuation of the transport plan implementation.
